264 Commerce Center: A Tilt-Up Warehouse on Produce Road, Month by Month

From a graded lot in May 2025 to a finished Class A warehouse in April 2026, flown month after month for Duane Realty Group.

Shaun WilsonFAA Part 107 licensed pilot 4 min read

In May 2025 the lot at 3910 Produce Road was graded dirt beside an older warehouse. By April 2026 it was 264 Commerce Center: a 119,850 square foot Class A warehouse and distribution building with 32-foot clear height, 16 dock doors and a 140-foot truck court.

I flew it for Duane Realty Group the whole way, month after month, from the same corner of the site each time. This is the full story of that year: every visit, the day the walls went up, the steel, the snow, the finished building and the marketing film that came out of it.

Drag through the year

Every frame below is shot from the same corner of the site, so the only thing that changes is the building. Press play to watch the year go by, or pick a month.

May 2025: the graded site for 264 Commerce Center on Produce Road in Louisville before the slab
May 2025

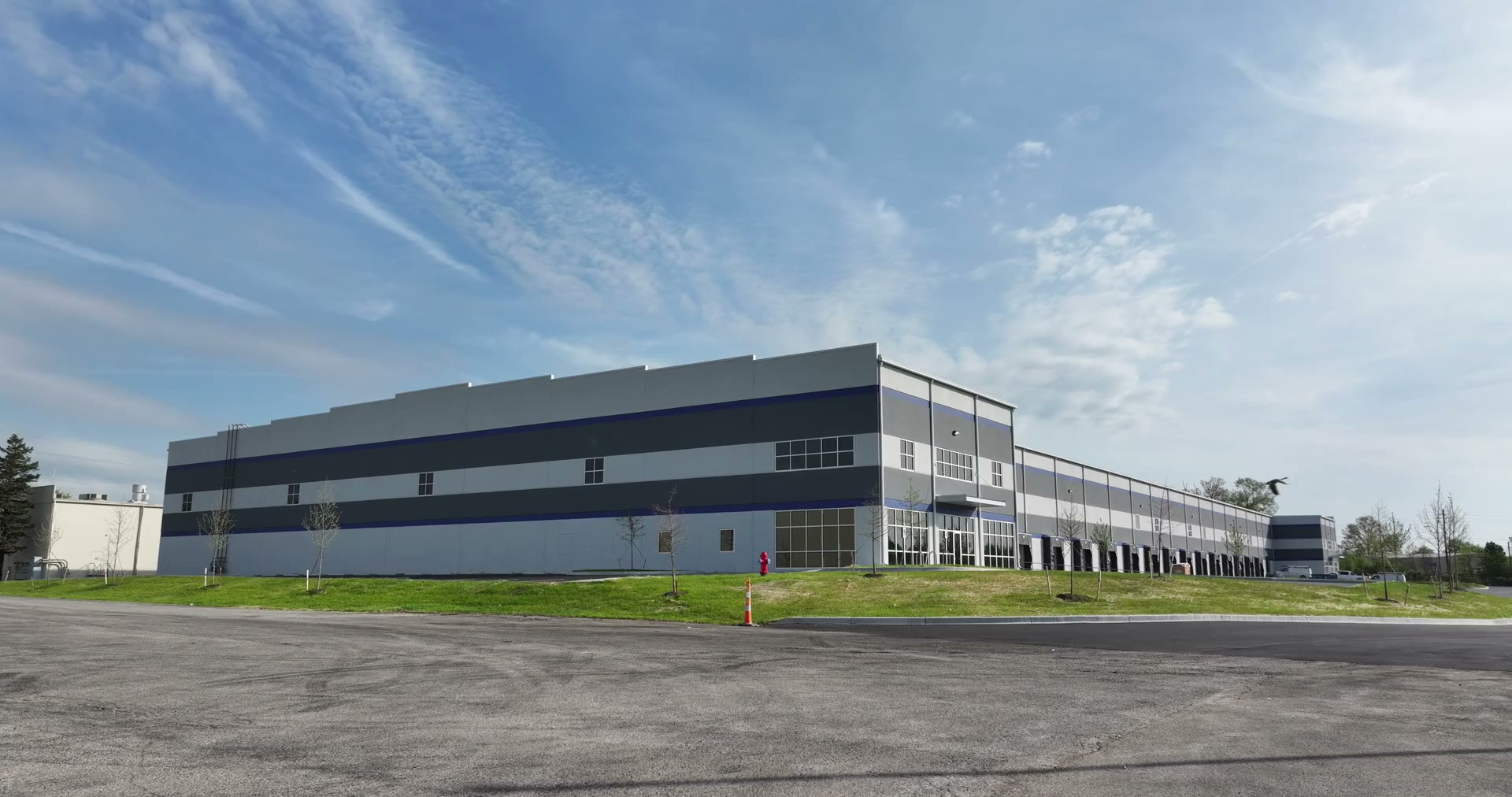

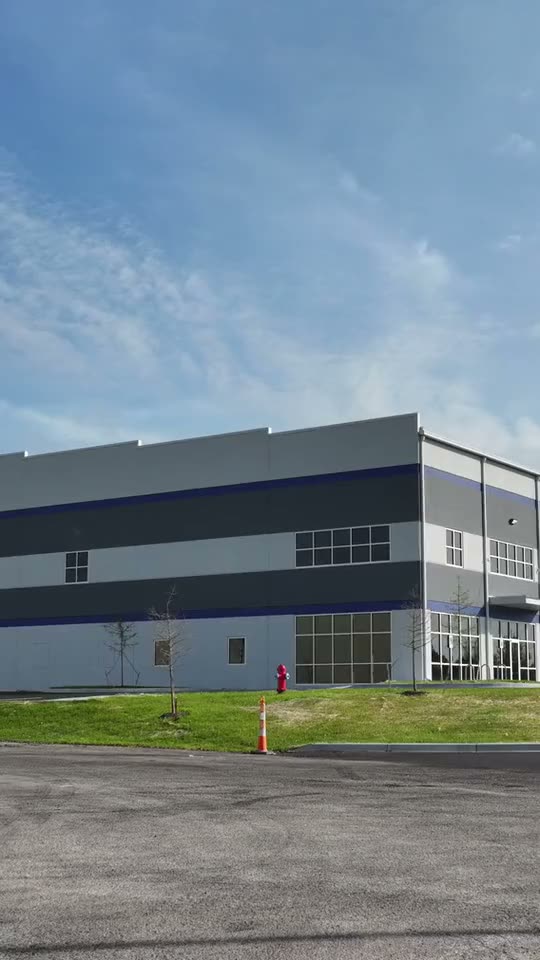

April 2026: the finished 264 Commerce Center warehouse on Produce Road in Louisville
May 2025: the graded site for 264 Commerce Center on Produce Road in Louisville before the slab
May 2025April 2026
Drag to compare: the graded lot on the first visit, and the finished 264 Commerce Center eleven months later.

The film

Halfway through the build, Duane Realty asked for something they could market the building with. I cut the tilt-up footage, the finished-building renderings and their leasing details into a single film for their brokers, website and social media. The team called it perfect.

264 Commerce Center - Duane Realty Group, July 2025

The days the walls went up

Tilt-up construction is the most dramatic part of a build like this. The wall panels are poured flat on the slab, then a crawler crane lifts each one, stands it on end and holds it while the crew braces it into place. I flew two days in a row in July 2025 to catch it: from the first panels on July 22 to nearly the whole perimeter standing on July 23.

These are short, silent clips straight from those flights and the ones after:

A wall panel leaving the slab, July 22, 2025
The crane walking a panel up while the crew guides it, July 23, 2025
Roof steel going in across the new walls, October 2025
The finished office front and parking, April 2026

Steel, roof and shell

By September the walls were standing and roof steel was going on. October brought joists and deck across the whole footprint, and by early November the building was a finished blue and white shell with paving under way.

Through the winter

The December visit came after the first snow, with the entrance and truck court in place. In January there was not enough new work to justify a flight, so Duane Realty and I skipped it. In February we waited for the snow to melt off the truck courts before flying again, so the photos would show the site and not the weather.

Finished

The last visit was on April 14, 2026, with the paving striped, the grass in and the building ready for a tenant.

264 Commerce Center at a glance

From Duane Realty Group’s leasing details for the building:

  • 119,850 square feet of new construction, demisable, with up to 3,000 square feet of build-to-suit office
  • Tilt-up concrete construction on a 6 inch reinforced concrete slab
  • 32 foot clear height and 51’8″ x 68’4″ column spacing
  • 16 dock doors (14 with levelers and shelters), expandable, plus 2 drive-ins (14′ x 16′)
  • 140 foot truck court with a concrete dolly pad
  • ESFR sprinkler, LED lighting and 1600 amp, 480 volt, 3-phase power
  • 105 parking spaces, expandable, and M3 zoning
  • An infill location off Poplar Level Road near I-264, UPS Worldport and the Louisville airport

What a year of progress flights gives a developer

  • A dated record of every stage, from grading to occupancy, shot from the same positions so the months line up
  • Photos the leasing team can use long before the building is finished
  • A marketing film that sells the space while the walls are still going up
  • Proof for owners, lenders and partners without sending anyone to the site

Each visit was delivered by download link, with photos and 4K video in their own folders, and the schedule moved with the work: two days in a row for the tilt-up, a skipped month when nothing had changed, and a wait for the snow to clear.

Planning a build in Louisville?

I document construction projects across Louisville, Kentucky and Southern Indiana on a monthly or milestone schedule. See how a construction progress photography schedule works, add construction progress video, or call or text (502) 387-1142.

Want your build documented like this?

I fly monthly and milestone progress for contractors, developers and owners across Kentucky and Southern Indiana. Send the site and the schedule and I will put together a plan and a quote.
